Fase CP: Understanding Critical Path in Project Management

Understanding Critical Path (CP) in project management is super important for keeping projects on track. Guys, have you ever felt like you’re juggling a million things at once in a project? Knowing the critical path method can seriously save your sanity. Let’s break down what the critical path is all about and why it matters.

What is the Critical Path?

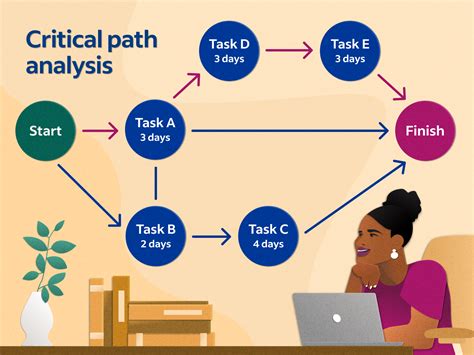

The critical path is basically the longest sequence of activities in a project plan that must be completed on time for the project to finish by its deadline. These activities are called critical activities . If any of these critical activities are delayed, the entire project gets delayed. Think of it like a chain: if one link breaks, the whole chain falls apart. Identifying the critical path helps project managers prioritize tasks, allocate resources effectively, and keep everyone on the same page.

Key Concepts of Critical Path

To really grasp the critical path, there are a few key ideas you’ve gotta know:

  1. Activities and Tasks : These are the individual jobs that need to get done in a project. Each activity has a start and end date, and requires resources like time, money, and people.
  2. Dependencies : This is how activities relate to each other. Some tasks can’t start until others are finished. For example, you can’t start painting a room until the drywall is up.
  3. Lead Time and Lag Time : Lead time is when you can start a successor task before the predecessor is totally done. Lag time is a delay you add between activities. Imagine needing to wait 24 hours for concrete to dry—that’s lag time!
  4. Float or Slack : This is the amount of time an activity can be delayed without delaying the entire project. Critical activities have zero float, meaning any delay will push back the project finish date.

Understanding these concepts helps project managers to map out the project efficiently and identify potential bottlenecks.

Why is the Critical Path Important?

Knowing the critical path is like having a roadmap for your project. It helps you see which tasks are most important and where you need to focus your energy. Here’s why it’s so valuable:

Prioritization

The critical path lets you prioritize tasks. You know which activities absolutely must stay on schedule, so you can make sure those get the attention they need. It’s all about focusing on what truly matters.

Resource Allocation

By identifying critical activities, you can allocate resources like time, money, and manpower more effectively. This means you’re not wasting resources on tasks that have some wiggle room.

Timeline Management

The critical path gives you a realistic project timeline. You’ll know the minimum time needed to complete the project, and you can set expectations accordingly. No more guessing games!

Risk Management

Understanding the critical path helps you identify potential risks and plan for them. If you know a critical activity is prone to delays, you can come up with backup plans to keep the project on track.

Communication

It improves communication among team members. Everyone knows which tasks are critical, so they can coordinate their efforts and avoid delays.

How to Identify the Critical Path

Alright, so how do you actually figure out the critical path ? Here’s a step-by-step guide to help you through it:

Step 1: List All Activities

Start by listing all the activities needed to complete the project. Be specific and break down large tasks into smaller, manageable steps. It’s like making a detailed to-do list.

Step 2: Identify Dependencies

Figure out the dependencies between activities. Which tasks need to be completed before others can start? Use a dependency diagram or network diagram to visualize these relationships. This is where you map out how all the pieces fit together.

Step 3: Estimate Activity Durations

Estimate how long each activity will take to complete. Be realistic, and consider potential challenges. Use past data, expert opinions, or similar projects as a reference.

Step 4: Calculate Early Start (ES), Early Finish (EF), Late Start (LS), and Late Finish (LF)

For each activity, calculate these four values:

  • Early Start (ES) : The earliest an activity can start.
  • Early Finish (EF) : The earliest an activity can finish.
  • Late Start (LS) : The latest an activity can start without delaying the project.
  • Late Finish (LF) : The latest an activity can finish without delaying the project.

These calculations help you understand the flexibility of each task.

Step 5: Determine Float or Slack

Calculate the float or slack for each activity by subtracting the Early Start from the Late Start (LS - ES) or the Early Finish from the Late Finish (LF - EF). Activities with zero float are on the critical path.

Step 6: Identify the Critical Path

The critical path is the sequence of activities with zero float. These are the tasks that must be completed on time to avoid delaying the project. Mark these activities clearly in your project plan.

Example

Let’s say you’re planning a website launch . Here’s a simplified example:

  1. Plan Website (2 weeks)
  2. Design Website (3 weeks) (depends on Plan Website)
  3. Develop Website (5 weeks) (depends on Design Website)
  4. Test Website (2 weeks) (depends on Develop Website)
  5. Launch Website (1 week) (depends on Test Website)

If each task must be completed in sequence, the critical path is: Plan Website → Design Website → Develop Website → Test Website → Launch Website. The total duration of the critical path is 2 + 3 + 5 + 2 + 1 = 13 weeks. If any of these tasks are delayed, the website launch will be delayed.

Tools for Identifying the Critical Path

Luckily, you don’t have to do all these calculations by hand. There are lots of tools out there to help you identify the critical path. Here are a few popular options:

Project Management Software

Tools like Microsoft Project, Asana, and Jira have built-in features for identifying the critical path. Just enter your tasks, dependencies, and durations, and the software will do the rest. These tools often provide Gantt charts and other visualizations to help you see the critical path at a glance.

Spreadsheets

You can also use spreadsheets like Excel or Google Sheets to calculate the critical path. This requires more manual work, but it’s a good option if you’re on a budget.

Online CPM Calculators

There are many free online calculators that can help you determine the critical path. Just enter your activities, dependencies, and durations, and the calculator will show you the critical path. These calculators are often simple and easy to use.

Tips for Managing the Critical Path

Once you’ve identified the critical path , here are some tips for keeping it on track:

Regular Monitoring

Keep a close eye on critical activities. Track their progress and watch out for potential delays. Regular monitoring helps you catch problems early.

Proactive Problem Solving

If you see a critical activity falling behind, take action immediately. Identify the cause of the delay and come up with a plan to get back on track. Don’t wait until it’s too late!

Communication

Keep everyone informed about the status of critical activities. Regular communication helps team members coordinate their efforts and avoid surprises.

Flexibility

Be prepared to adjust your project plan if necessary. Unexpected events can happen, so it’s important to be flexible and adapt to changes. Have backup plans in place for critical activities.

Resource Management

Make sure critical activities have the resources they need. Allocate resources effectively and be prepared to reallocate them if necessary.

Common Pitfalls to Avoid

Even with a solid understanding of the critical path , there are some common mistakes that project managers make. Here are a few pitfalls to avoid:

Inaccurate Estimates

If your activity duration estimates are inaccurate, your critical path will be wrong. Be realistic and consider potential challenges when estimating durations.

Ignoring Dependencies

Failing to identify all dependencies between activities can lead to delays. Make sure you have a clear understanding of how all the tasks relate to each other.

Lack of Monitoring

If you don’t monitor critical activities regularly, you won’t catch delays until it’s too late. Keep a close eye on critical tasks and take action immediately if they fall behind.

Poor Communication

Poor communication can lead to misunderstandings and delays. Keep everyone informed about the status of critical activities.

Conclusion

Understanding the critical path is essential for successful project management. By identifying critical activities and managing them effectively, you can keep your projects on track and achieve your goals. So, guys, take the time to learn about the critical path method, and you’ll be well on your way to becoming a project management pro! Whether you’re using project management software or a simple spreadsheet, mastering the critical path will help you deliver projects on time and within budget.
